Control Report
Overview
This report is intended to support delivery of your capacity plans, it shows you how your teams and departments are progressing against their plans so that you can make informed decisions about what they need to do today, this week or this month to deliver on their plans. You can also use it to analyse variances from plan retrospectively to understand what caused any significant variances, the impact they had on the team and the actions that were taken to minimise that impact. This analysis can then inform future plans.

Because this report is intended to support delivery of plans you would typically only run it for a period of time that you have a balance and committed plan in place for.

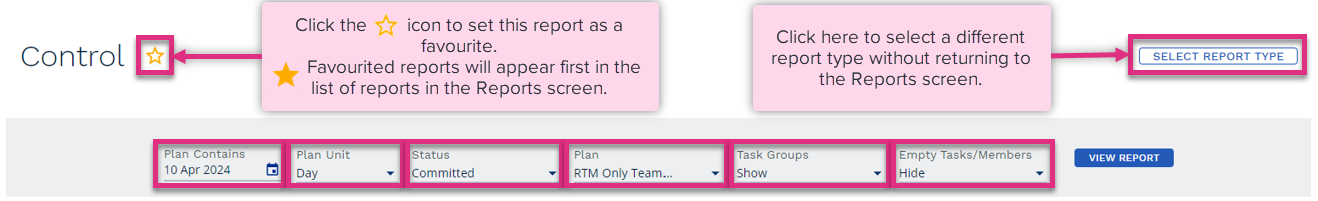

Plan Contains
Plan Unit
Status
Plan
Tasks Groups
Empty Tasks/Members
View Report
|

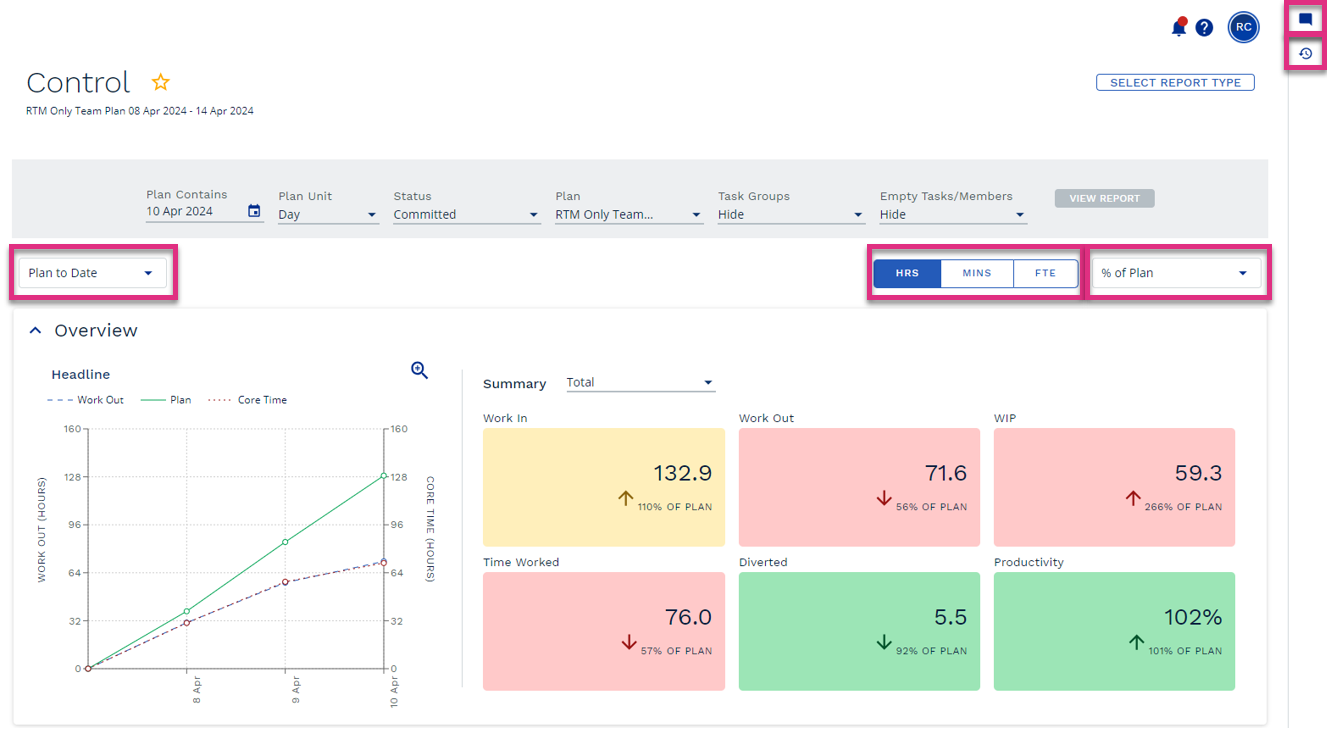

Plan to Date
Report Intervals
% of Plan
|

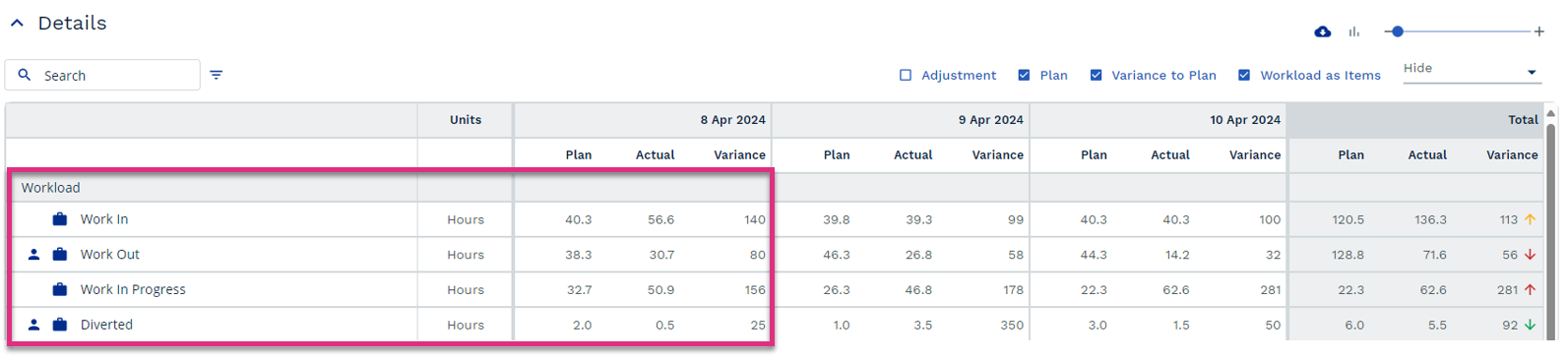

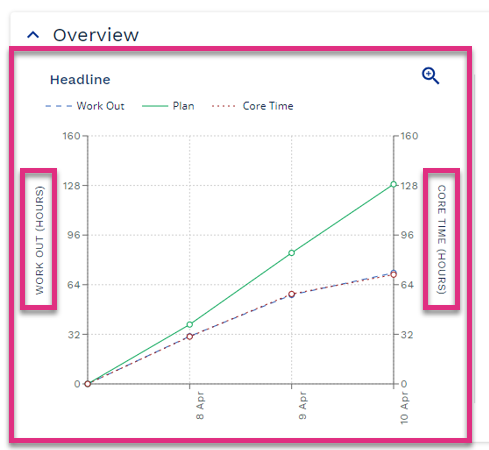

This chart illustrates the Work Out that has been completed and the Core Time used compared to what you planned. This provides a view of how the workgroup are tracking compared to productivity targets.
![]() |
![]() |
The green line is the plan line and illustrates the planned hours of Work Out and the planned hours of Core Time for the whole of the plan period. |
![]() |
The blue line illustrates actual hours of Work Out captured. If this line is positioned above the plan line, then more Work Out than planned has been completed. If it is below, then less Work Out than planned has been completed. | |
![]() |
The red line illustrates the actual hours of Core Time used by the workgroup. If the red line is above the plan line, then more Core Time than planned has been used, if it is below then less Core Time than planned has been used. | |
![]() |
If the Work Out line is below the Core Time line then this means that the workgroup have completed less Core Work with more Core Time and are not achieving the planned level of Productivity. | |
![]() |
If the Work Out line is above the Core Time line then this means that the workgroup have completed more Core Work with less Core Time and are achieving a higher than planned level of Productivity. |

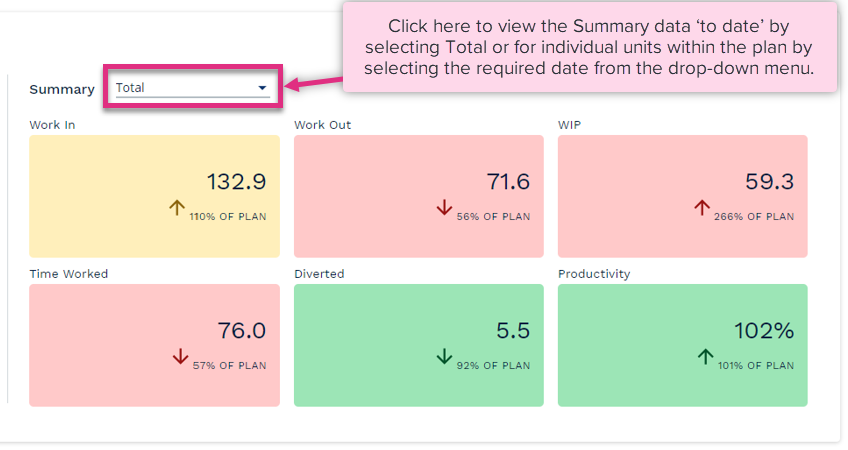

The summary tiles display comparison to plan data (variances) for key metrics these variances are marked as red, amber or green depending on the size of the variance as a percentage of plan. Red – Variance is 20%+ of plan. Amber – Variance is between 10% and 19% of plan. Green - Variance is between 0% and 9% of plan. |
![]() |
Work In
Work Out
WIP
Time Worked
Diverted
Productivity
|

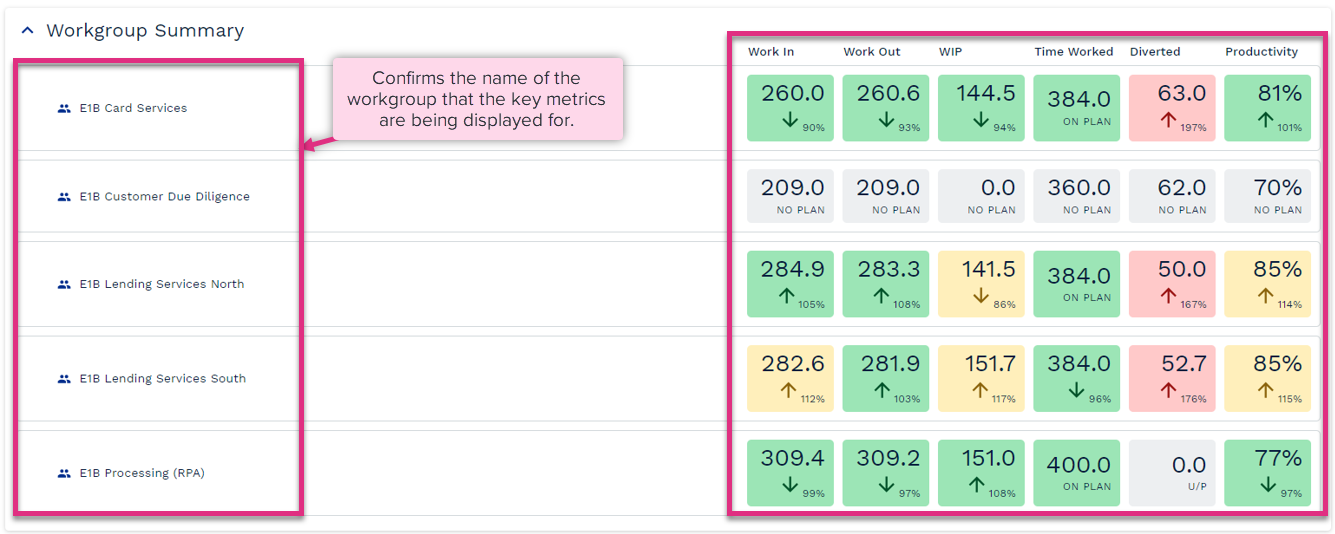

If you run a Control report at a level of the hierarchy higher than a team you will also see a Workgroup Summary table. This illustrates the key metrics for each of the child plans that are feeding into the workgroup you have run the report for. Please note this data is not displayed when the report is run for a team.
Work In
Work Out
WIP
Time Worked
Diverted
Productivity
|

Search
Filters
Hide / Show
Export / Graph / Resize

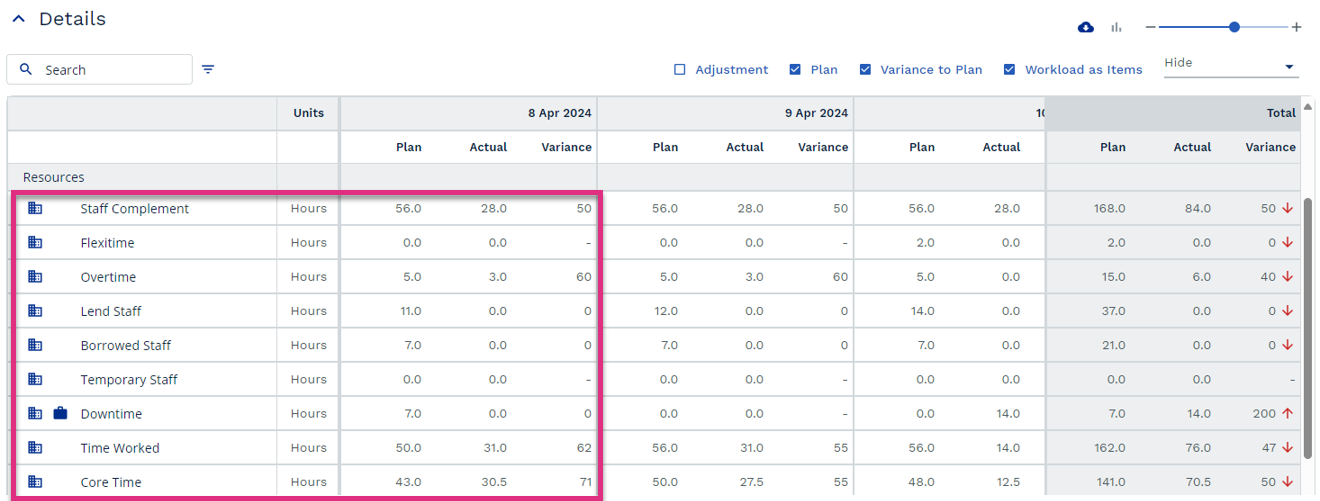

Units
Values
Totals
|

Work In
Work Out
Work In Progress
Diverted
Cost per Standard Hour
|

![]() ![]() |

Staff Complement
Flexitime
Overtime
Lend Staff
Borrowed
Temporary Staff

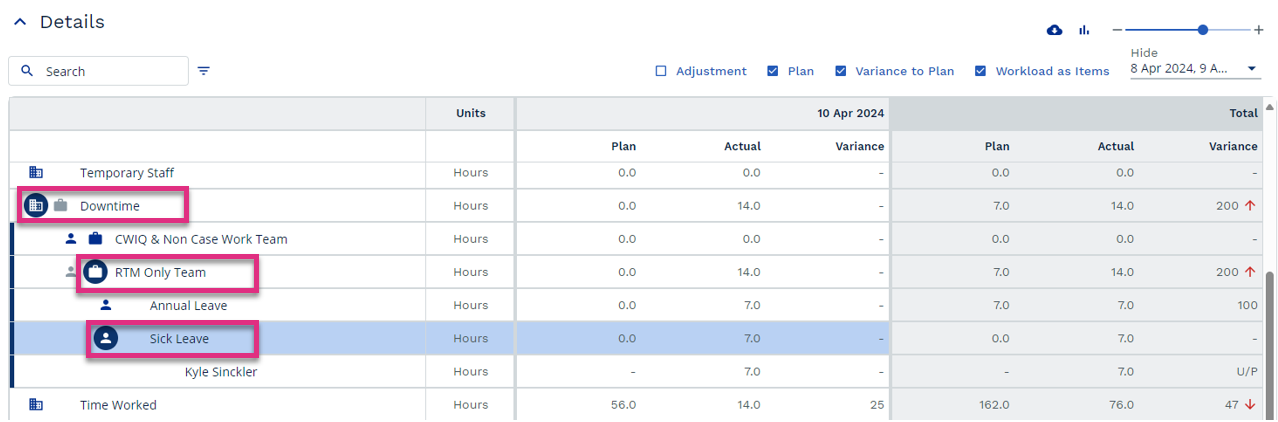

Downtime
Time Worked
Core Time
|

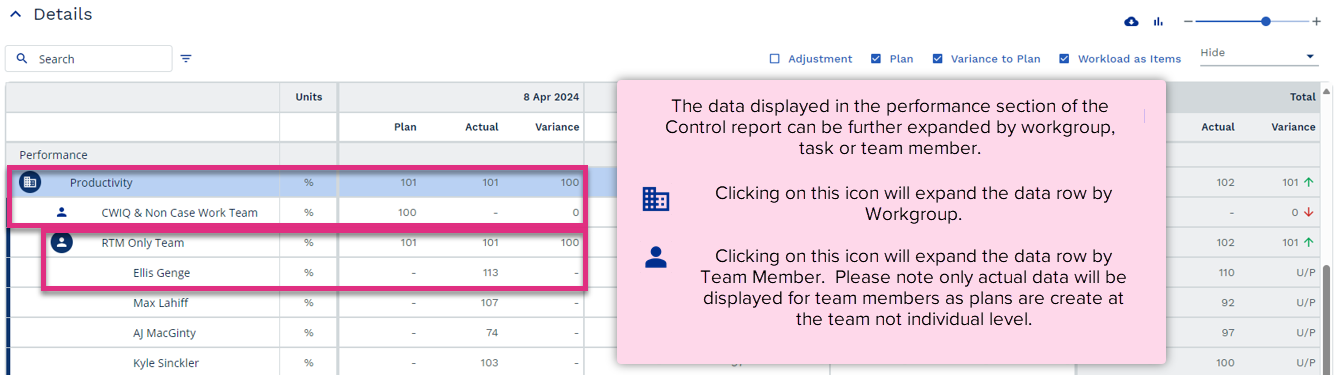

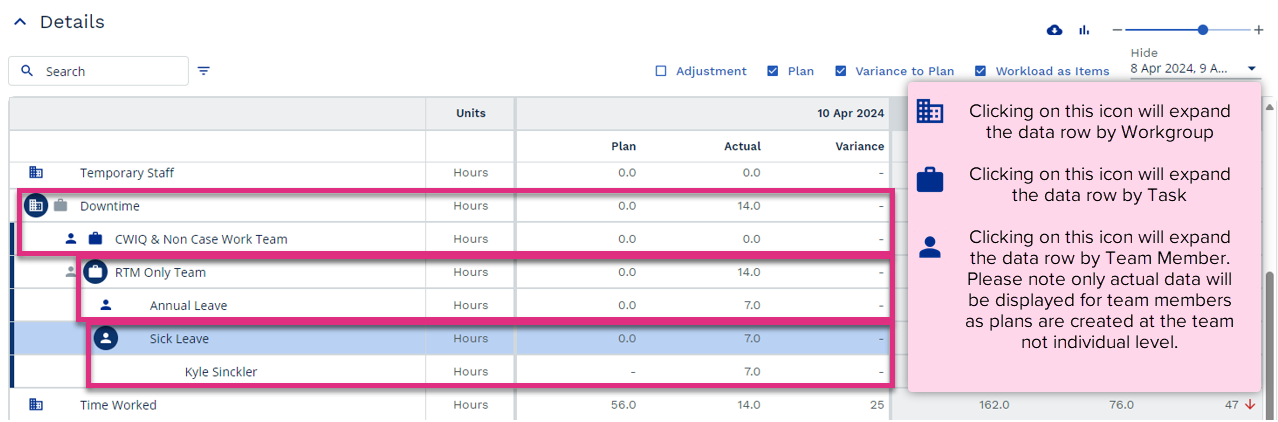

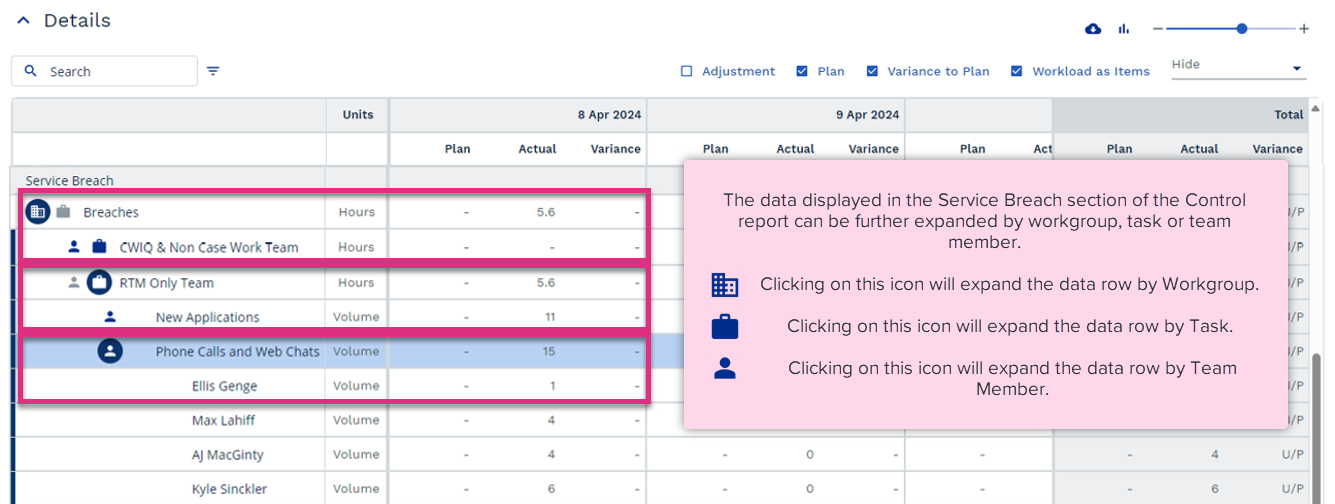

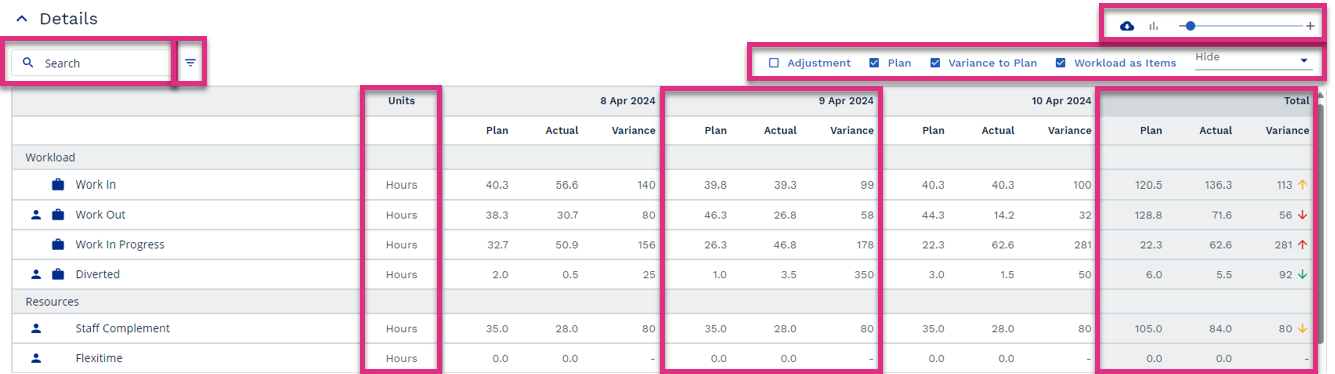

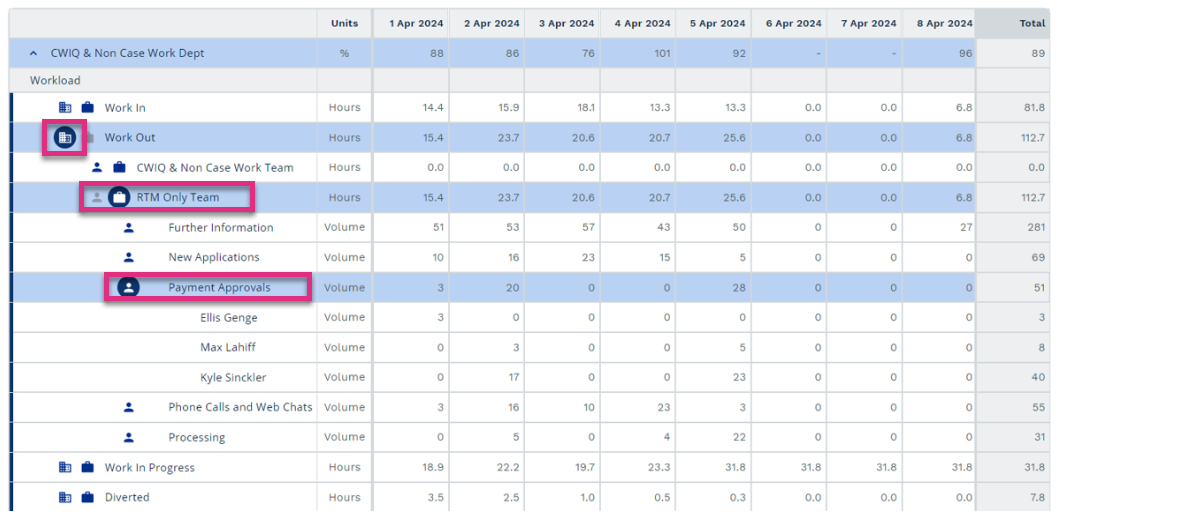

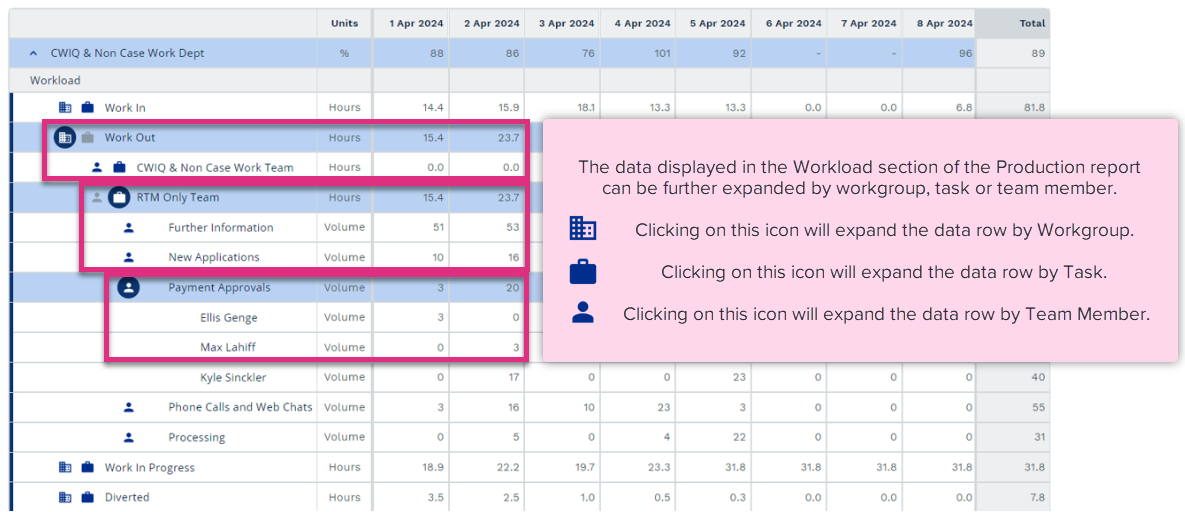

The data displayed in the Resources section of the Control report can be further expanded by workgroup, task or team member.

![]() ![]() |

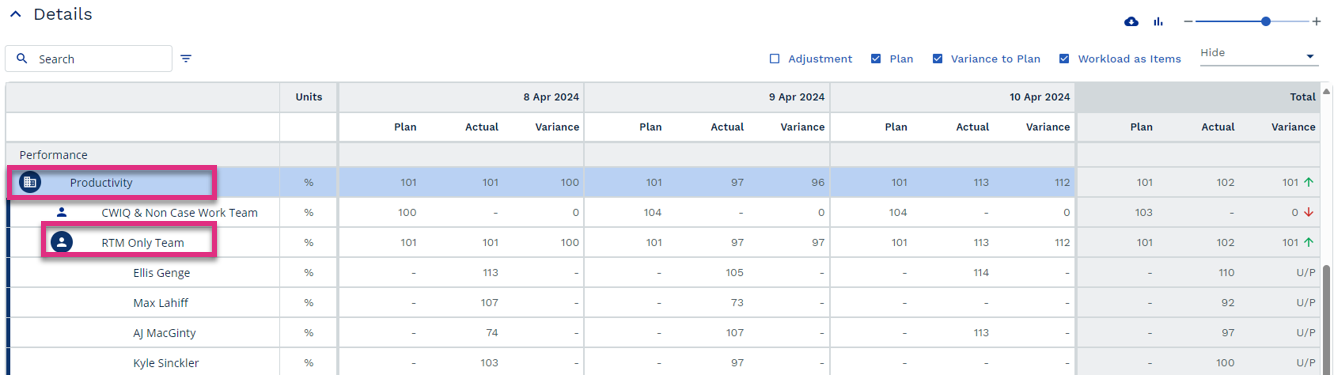

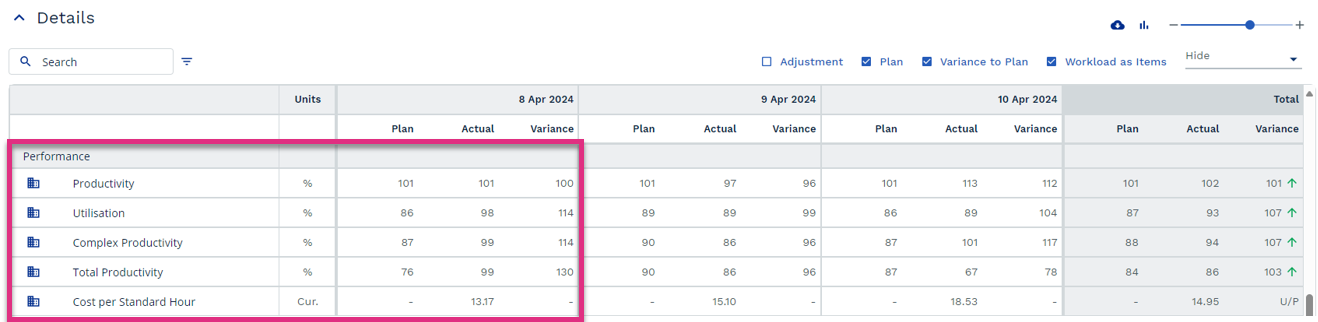

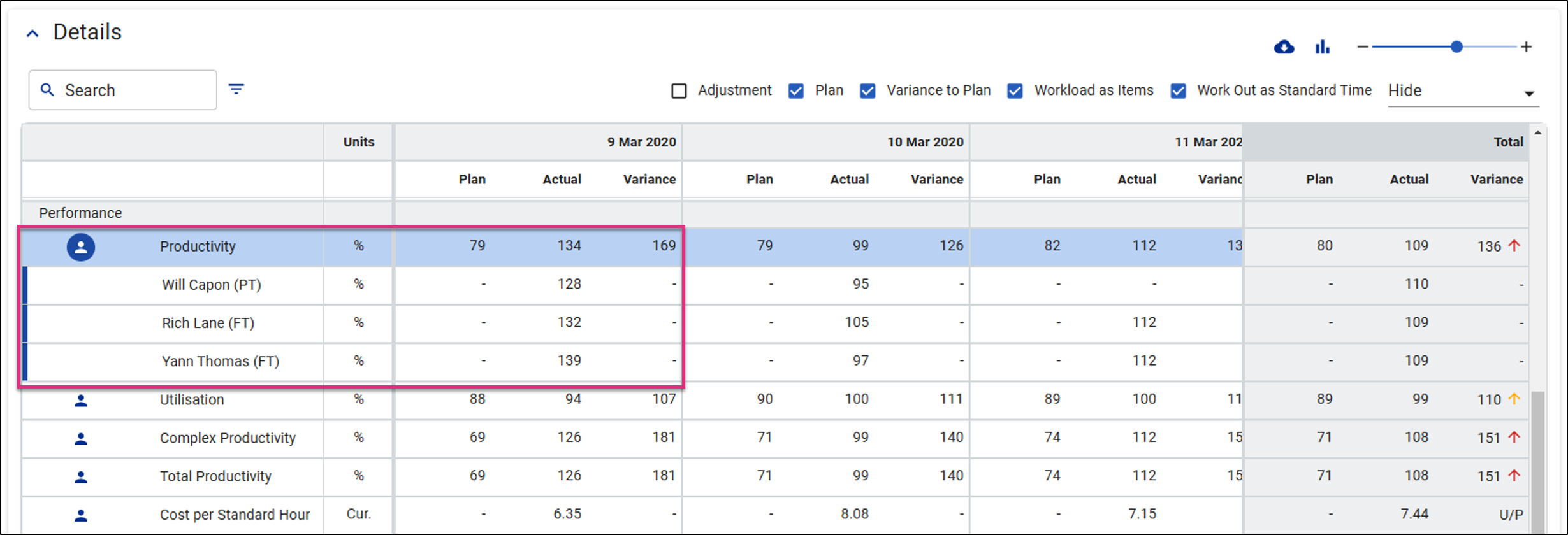

Productivity
Utilisation
Complex Productivity
Total Productivity
Cost per Standard Hour
|

![]() ![]() |

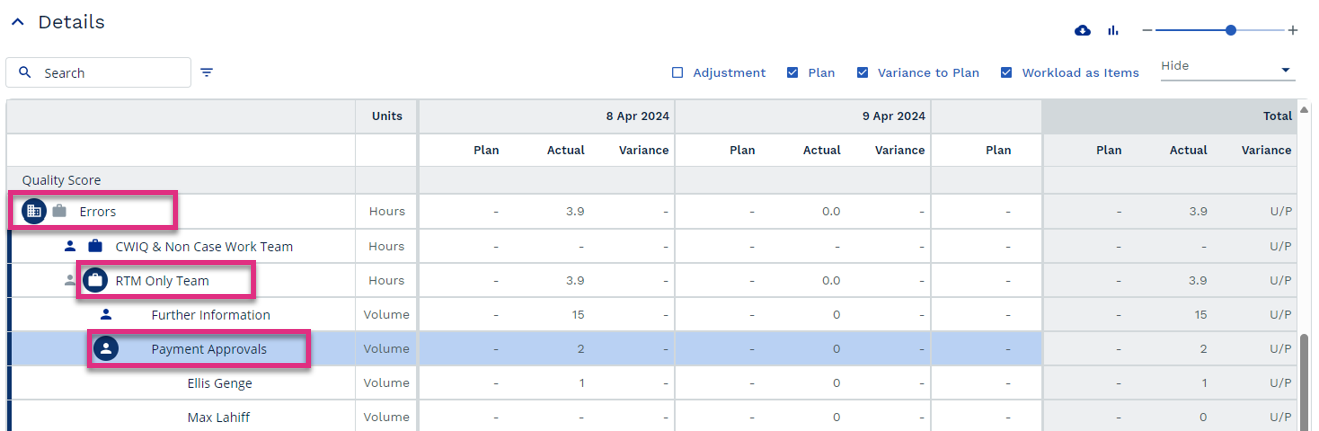

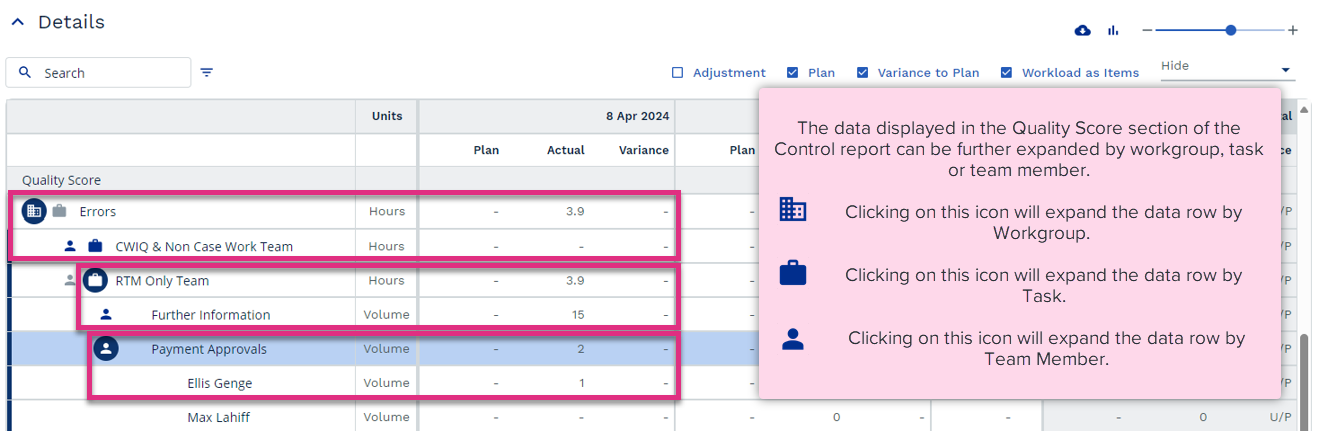

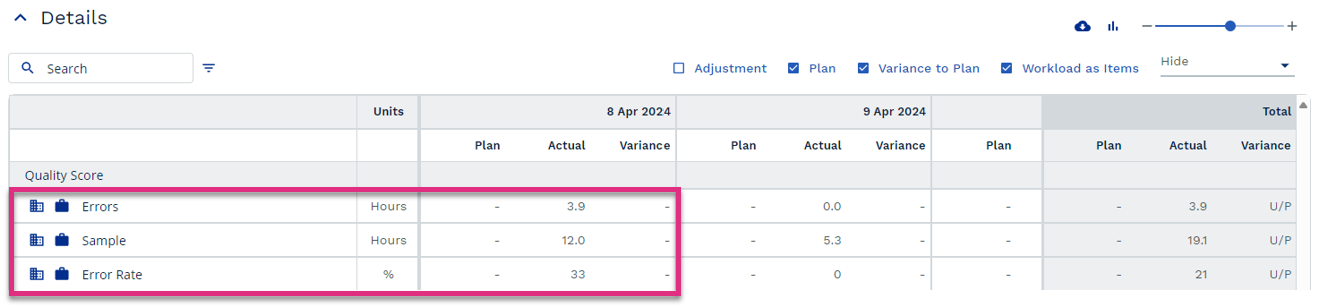

Errors
Sample
Error Rate
|

![]() ![]() |

Please note that only actual values will be displayed here. |

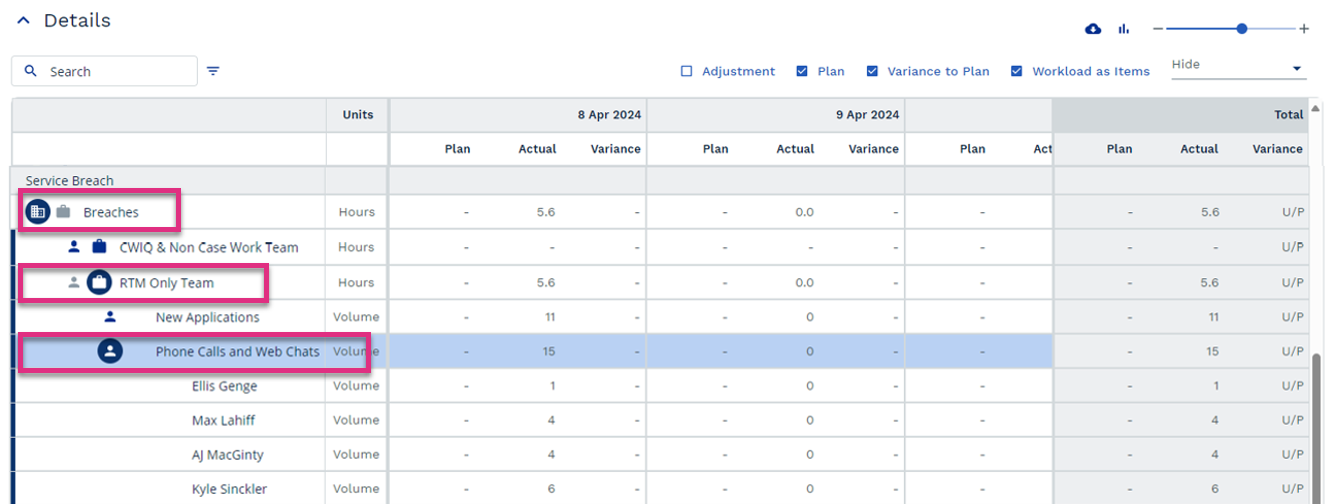

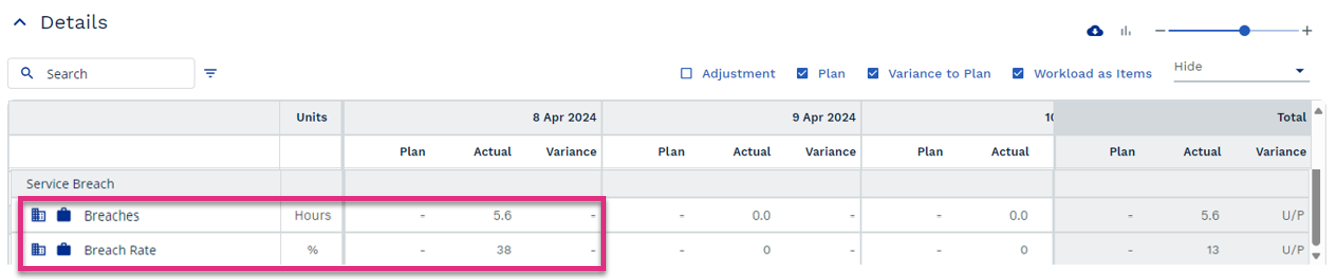

Breaches
Breach Rate
|

![]() ![]() |

Headline Charts
When reviewing the Control Report against a Case Plan the Work In Progress tile seen in the report for Task Plans will be replaced with a Cases Closed tile.

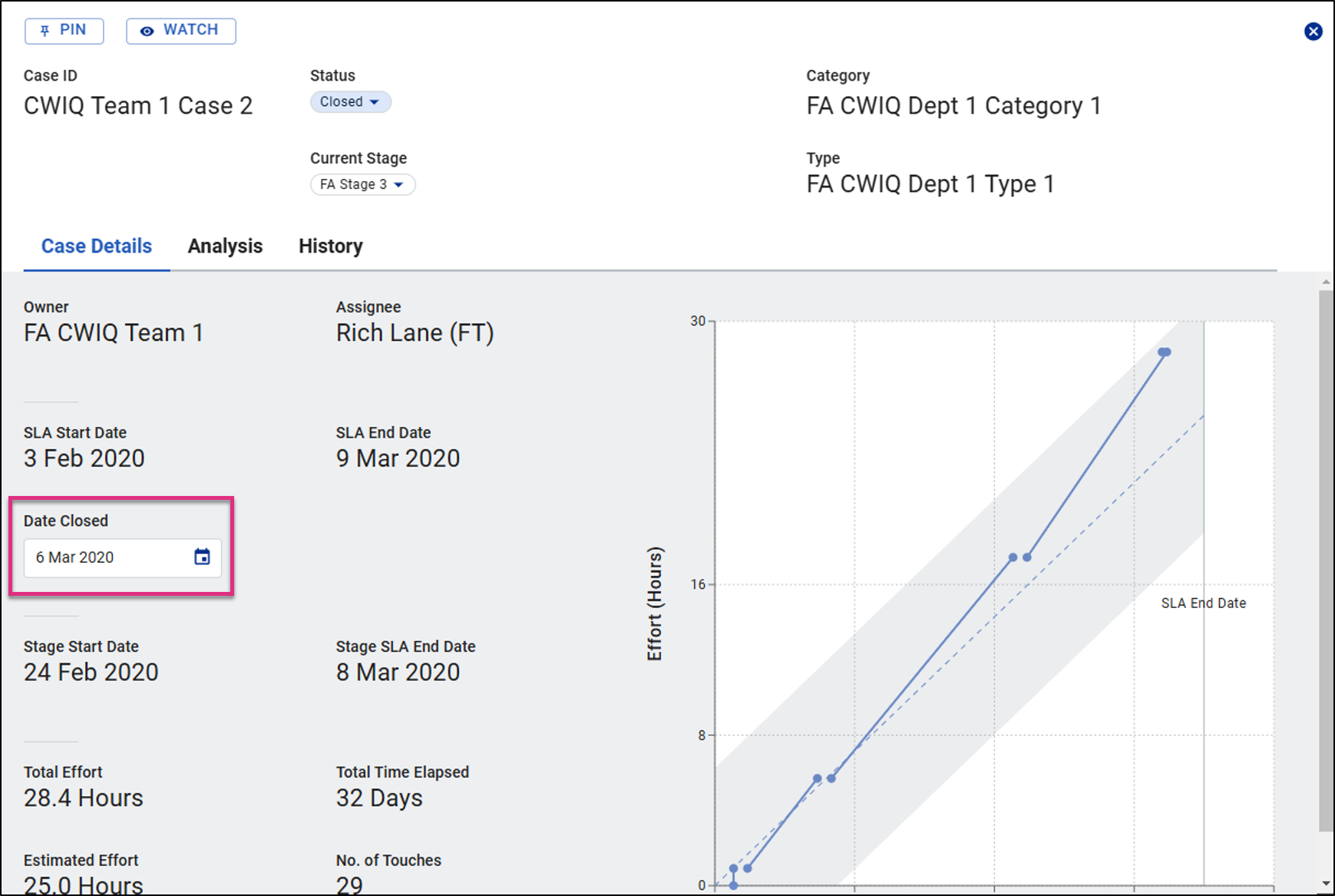

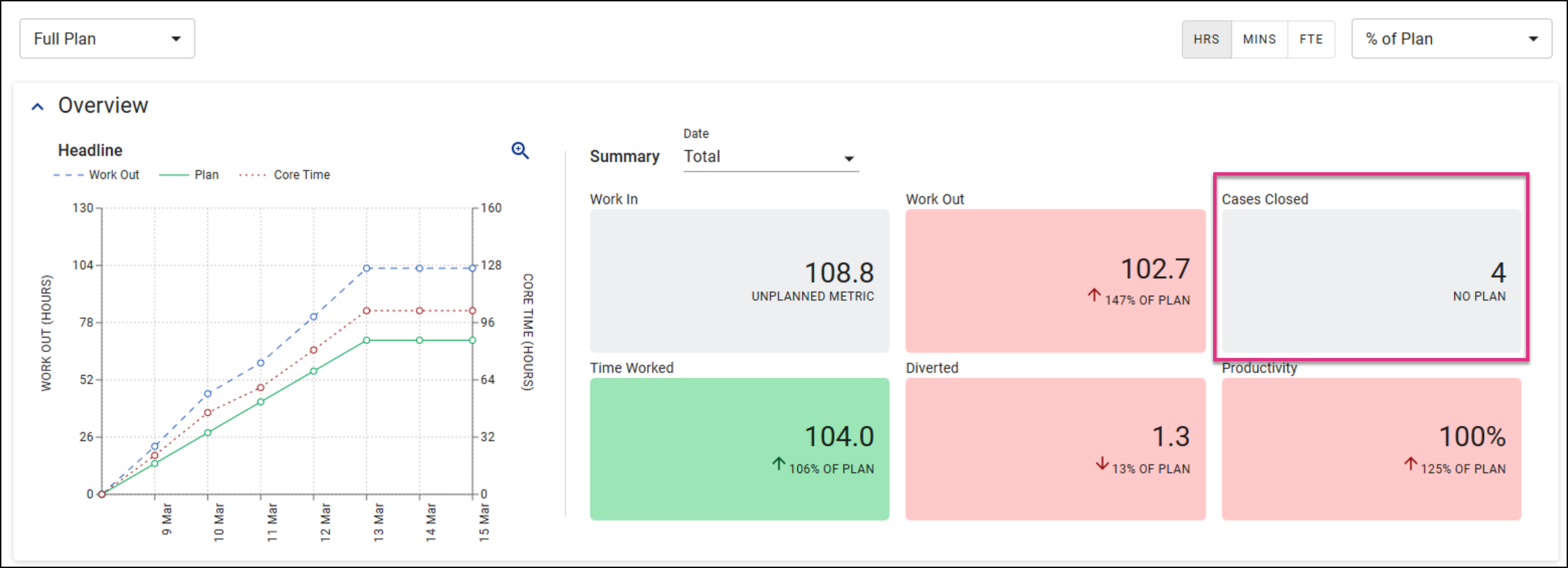

This will display the number of cases that have a closed date within the plan period.
The Work Out value displayed will be based on either the standard time associated to Core Tasks or the actual time captured in the Case Worklog depending on the option selected in the Details section of the report.
Work Out Details

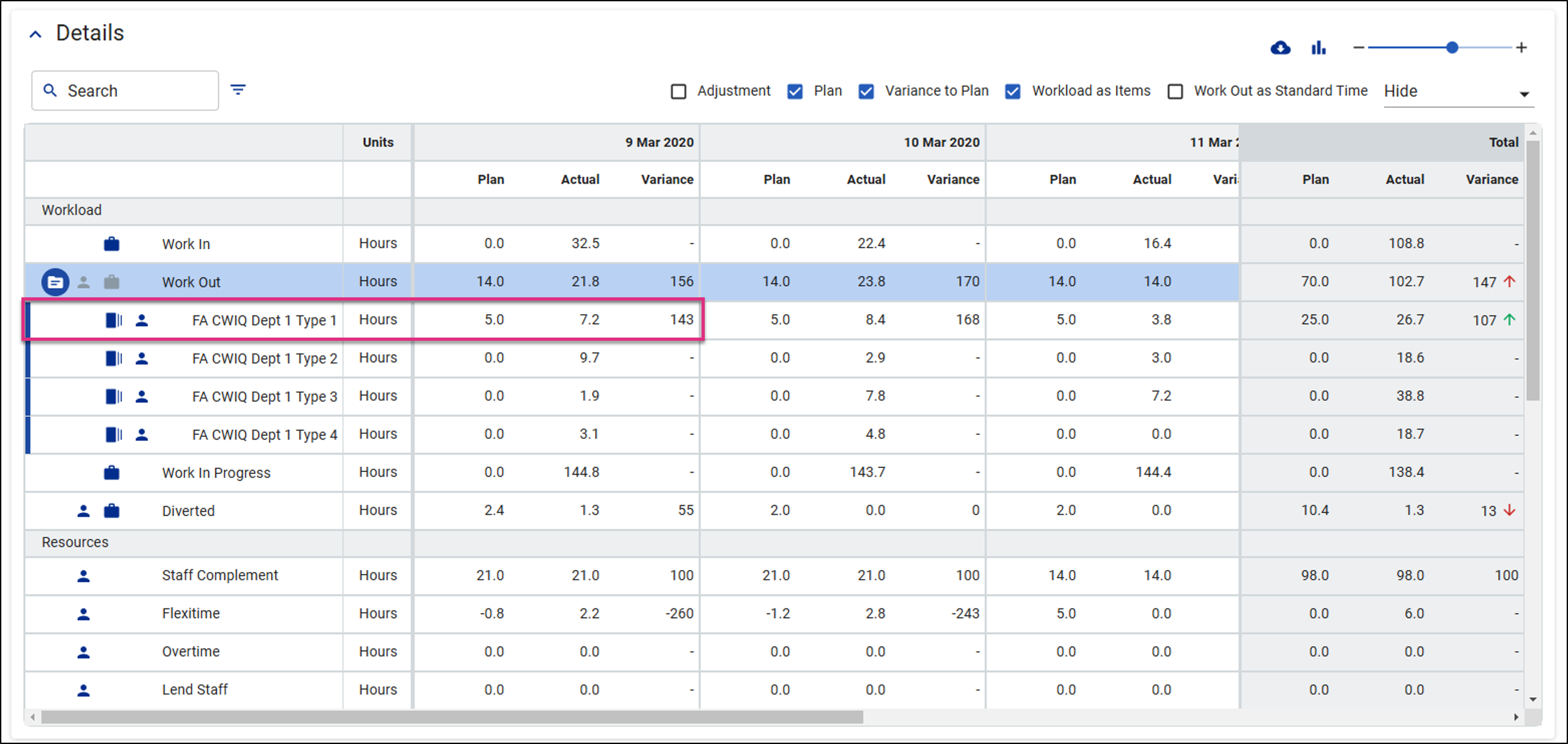

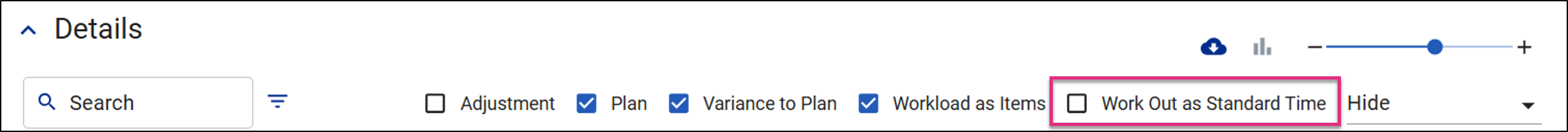

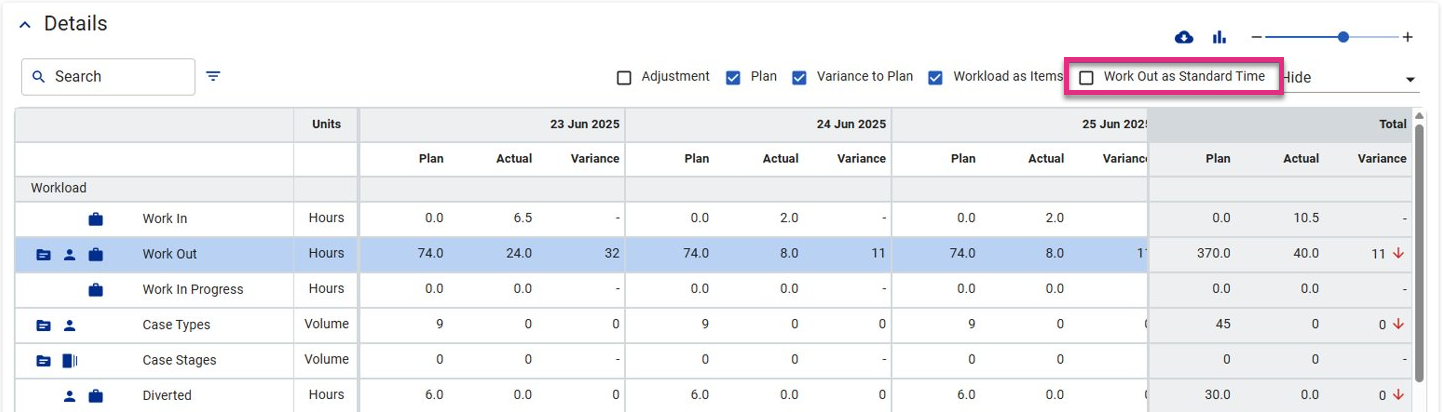

The Work Out as Standard Time check box allows you to choose between viewing work out values based on the items completed multiplied by the standard time for each core task, or by the actual time recorded in the Case Worklog.
The values shown for planned Work Out will be based on the standard time linked to each Case Type or Stage or the planned hours of effort dependent on the planning approach selected.

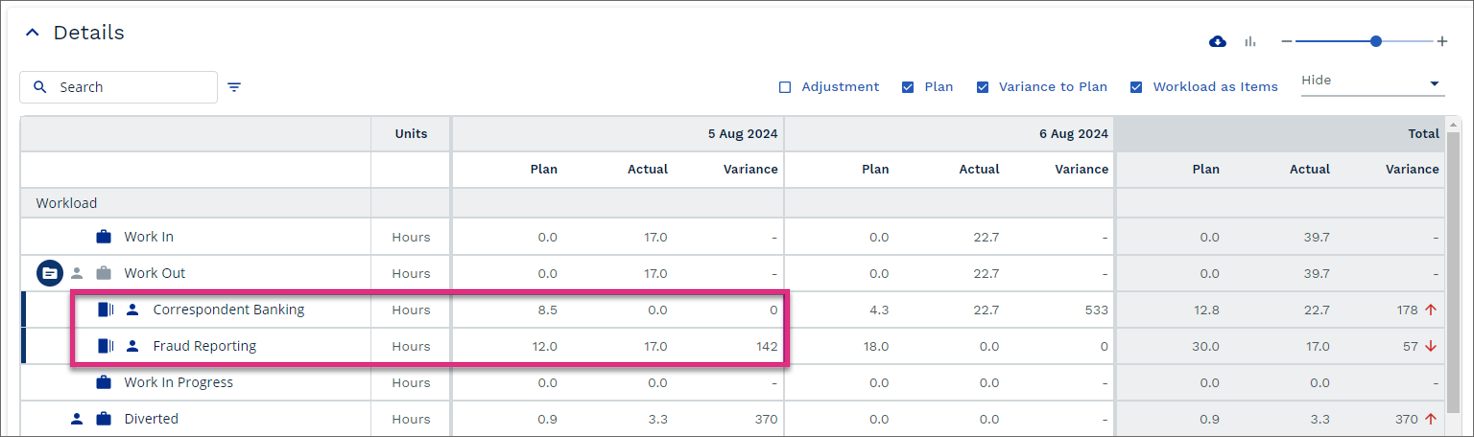

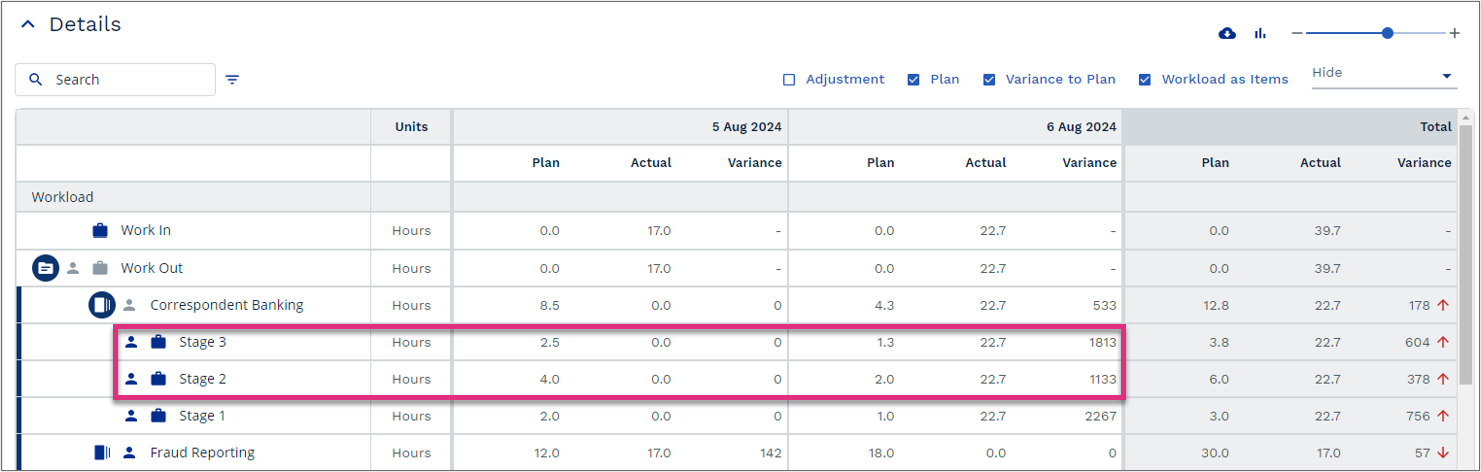

Select the icon to expand Work Out to show the planned and actual hours of Work Out by Case Type.

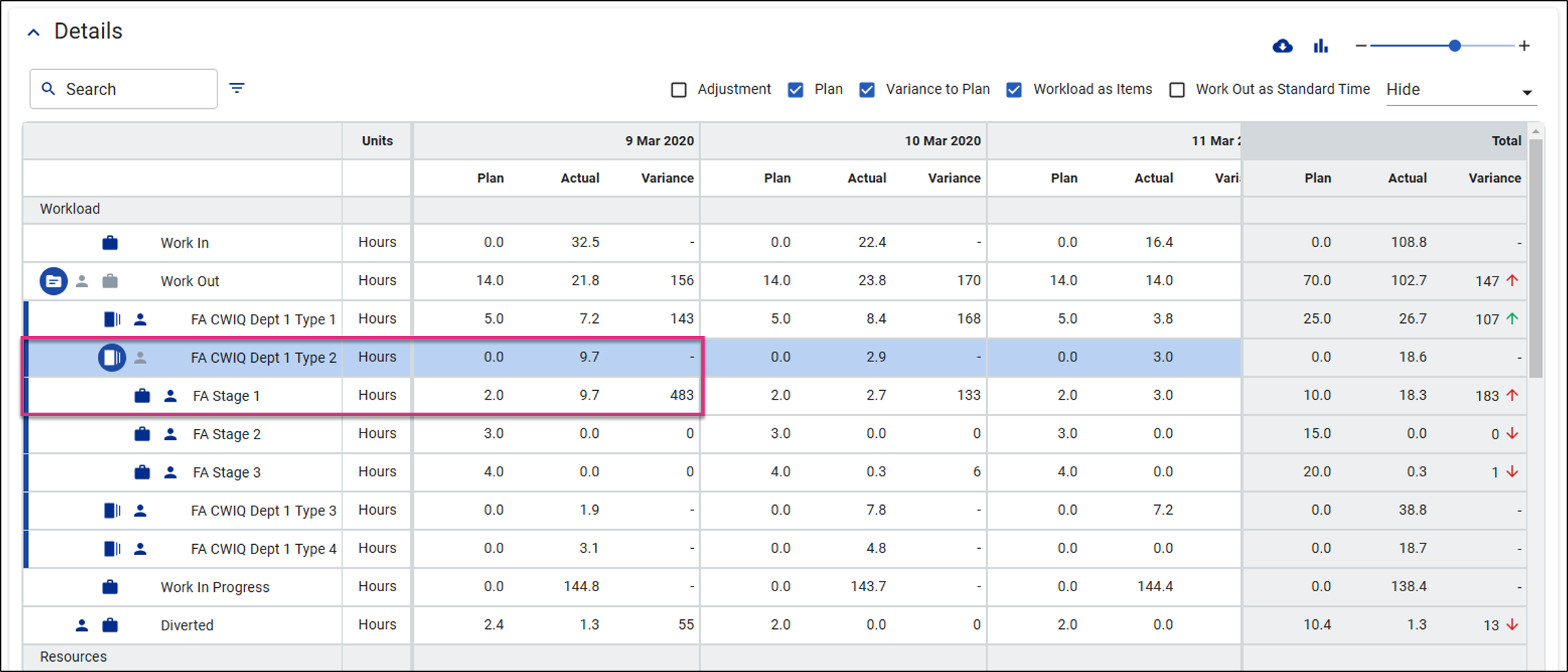

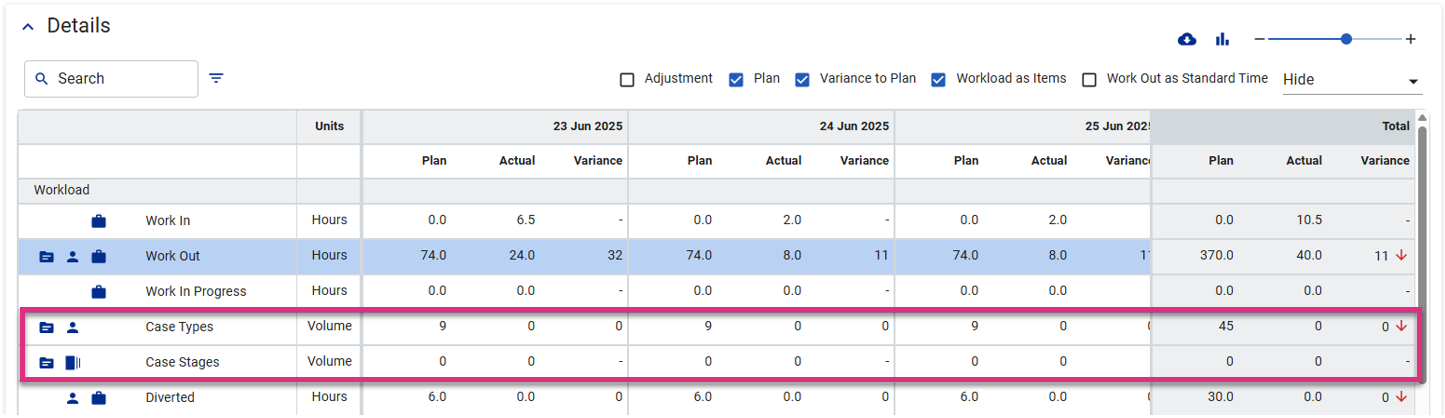

If you have planned at Case Stage level you will need to further expand the data to view planned and actual data at a Case Stage level by selecting the icon.

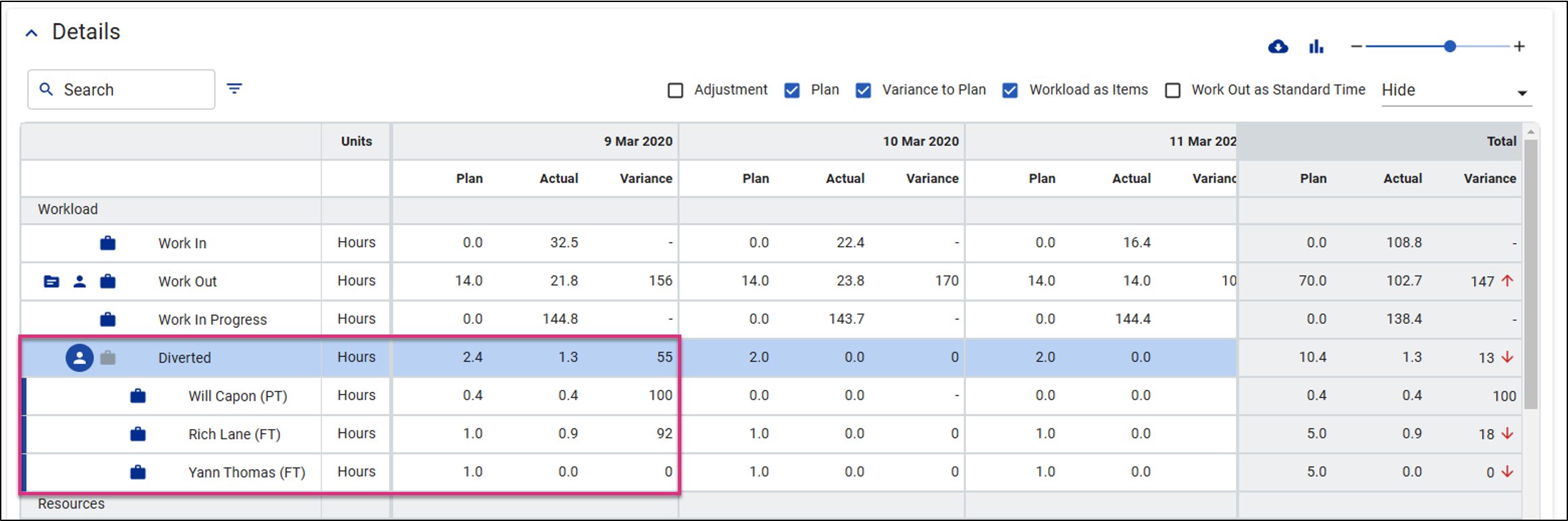

Diverted Time
If the plan has been created using the individual staff member feature for planning resource and diverted time the plan and actual values will be displayed when expanding these sections allowing for a more detailed view of what was planned and what actually happened.
Productivity
Productivity will display the actual values based on the Work Out as Standard Time option selected. If the check box is selected the productivity value displayed will be based on the items or core tasks completed multiplied by the standard times.
For more information on... | |
---|---|
Calculations |
See Key Equations |
Frequently Asked Questions | See FAQs |
Notes | See Notes |
